Case Studies/Healthcare
Healthcare · HVAC Controls + Lighting · 2024–2026

Pneumatic-to-DDC conversion and HVAC optimization for an acute-care hospital

San Leandro Hospital · Alameda Health System · 125,857 sq ft. Hospital-wide controls replacement, twenty new drives, plant converted to variable flow, air changes set to code, full LED. Permitted under HCAI and built with every department open.

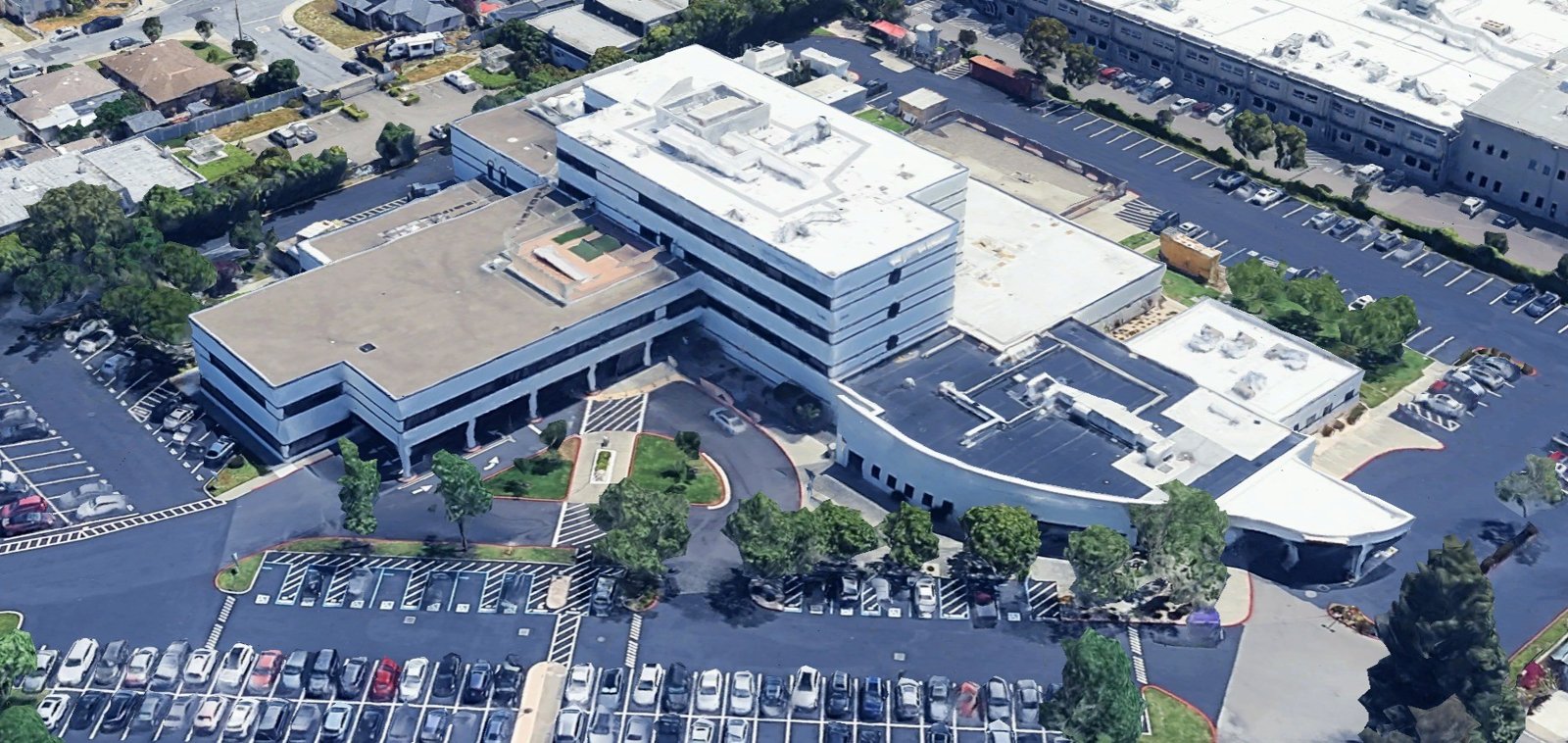

San Leandro Hospital aerial view
$594K
projected annual utility savings, board-approved, plus $29K in maintenance
$4M+
in rebates, incentives and 0% on-bill financing secured by EverWatt
1.28M kWh
projected annual electric savings, plus 99,300 therms of gas
45 → 6
air changes per hour in the CT scan room, brought to code
The problem

A hospital that met setpoint by moving three times the air it needed.

San Leandro Hospital was built in 1980 and, until 2024, ran on the pneumatic control system it was built with. The mechanical plant was in good condition and generally held temperature — but it did so with no sensors, no trending, no scheduling, and by moving far more air, water and heat than the building required. In 2023 the hospital used 3.5 million kWh and 147,000 therms at a cost of $1.29 million.

A single site walk would have documented the equipment and found nothing wrong. EverWatt instead installed loggers on every air handler, both plants and the lighting circuits for sixteen weeks, surveyed more than ninety pieces of equipment by nameplate, and compared the trends against the utility bills and the most recent test-and-balance report.

Boiler plantFirst-floor roof

Boiler plant and first-floor roof, April 2024 field survey.

What the data showed

The equipment wasn't failing. Nothing was telling it what to do.

CT scan room

45 total air changes an hour against a code value of 6; 19 outside-air changes against 2. Supply air swinging 61–71 °F through the day.

Emergency room air handler

Outside-air and exhaust dampers fully closed — recirculating 100% — and no actuator on the chilled-water valve. A patient-safety correction as much as an energy measure.

Operating rooms

Up to 43 air changes an hour against a requirement of 20.

Boilers

Running around the clock because three-way valves kept full flow at all times, regardless of load.

Chiller plant

Set to 54 °F because the excess airflow could not be cooled any lower. Second chiller failed.

Isolation rooms

Negative pressure monitored only by a local alarm at the door — no trend, no record, no notification to engineering.

What EverWatt did

Every measure traces to a finding.

Hospital-wide BACnet-native DDC replacing the pneumatics, twenty variable-frequency drives, plant re-piped to variable flow, air changes reset to the 2022 California Mechanical Code, and 1,028 fixtures converted to LED.

SystemWhat the survey foundWhat EverWatt did
AHU-1 · CT scan19 OA / 45 total ACH against 2 / 6. Supply swinging 61–71 °F.New controls and schedule; 6 ACH outside peak cooling; economizer modulation; loops tuned.
AHU-3 · EmergencyNo fresh air: dampers closed, 100% recirculation. No CHW valve actuator.Restored 2 OA / 6 total ACH per CMC Table 4-A; economizer under control; new actuator.
SF/RF-2 · Operating rooms26–43 ACH against 4 OA / 20 total.VFDs on supply and return; fan speed modulated to code; OR pressure relationships held.
SF-5 · Intensive care8 OA / 10 total ACH against 2 / 6.VFDs and controls to code; isolation and utility room pressures maintained.
Isolation roomsLocal pressure alarm only; no central record.Pressure tied into the BAS with trending and an alarm to engineering. Compliance recorded, not assumed.
Hot water plantBoilers 24 hours; three-way valves and bypass at full flow.Bypasses closed; pump VFDs; flow modulated to actual reheat demand.
Chilled water plant54 °F CHW and constant-flow bypass. Second chiller failed.Bypasses closed; pump VFDs; reset to 44 °F; owner's replacement chiller integrated.
Interior lightingLinear fluorescent throughout; AB 2208 bans fluorescent lamp sales from 2025.Full LED conversion of 1,028 fixtures; maintenance savings recognized in the board approval.
How it was funded and how it's verified

Zero out of pocket. Savings measured at the meter.

$4M+ in utility funding

Rebates, incentives and zero-interest on-bill financing over 82 months, secured by EverWatt before construction. The hospital paid nothing up front.

HCAI permitting and peer review

Permitted through HCAI (OSHPD-1) and defended through a mechanical peer review, with every department remaining in service during construction.

Meter-based verification

The utility's own engineer screened the electric meter for a meter-based measurement path before financing was approved. Twelve months of post-installation data settle the savings.
